The Installation Process of Ecotrend AAC Internal Wall Panel System
Home » Blogs » Knowledge » The Installation Process of Ecotrend AAC Internal Wall Panel System

The Installation Process of Ecotrend AAC Internal Wall Panel System

Views: 350     Author: Site Editor     Publish Time: 2021-01-05      Origin: Site Inquire

1. Application scope of Ecotrend AAC partition panel


-Apply to residential, office buildings, hotels and other public buildings.


2. Accessories and Tools


- L-Type Fastener  L-Type Fastener                                         - Gradienter Gradienter



- Nail gun Nail Gun                                                                        - Trolley Trolley



- Chalk line set Chalk line set                                                    - Shoot nail Shoot nail



- Rubber hammer Rubber hammer                                                - Portable cutting machine Portable cutting machine



- Crowbar Crowbar                                                                            - Trowel Trowel



- Level ruler Level ruler                                                             - Electric blender Electric blender



- Mud bucket Mud bucket                                                      - Wood wedges Wood wedges



- Special adhesive mortar Special adhesive mortar                                            - Tap measure Tap measure



- Frosted trowel Frosted trowel




3. The installation of Ecotrend AAC partition panel

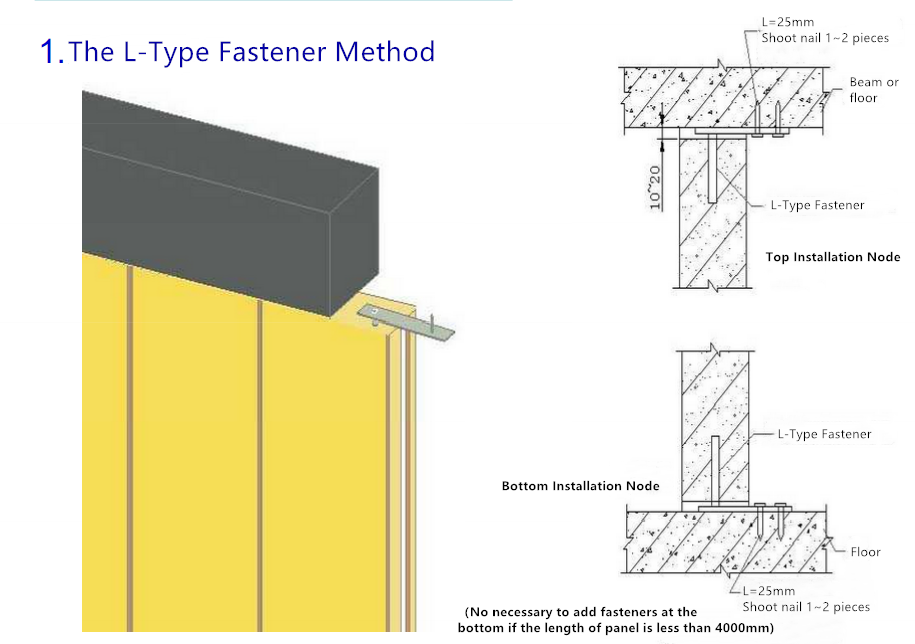

The L-Type Fastener Method

The U-Type Fastener Method

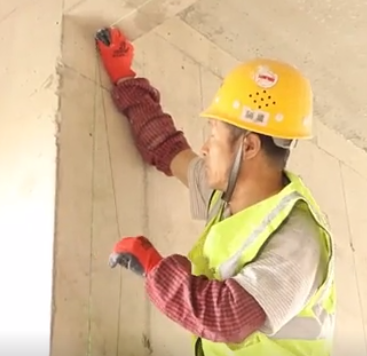

   1). Lay out wall lines


a. Clean up the field and lay out wall lines according to construction drawings.


b. Lay out position control lines at the top of concrete beam, floor slabs, side concrete columns and door-window openings.


c. Control the verticality and flatness of the wall, the position and elevation of the door-window openings.


Lay out wall lines


   2). Preparation before installation


a. Check the integrity of the panel.


b. Put the panel on the trolley and measure its size, precisely cut the panel according to actual length and width.


Preparation before installation-b

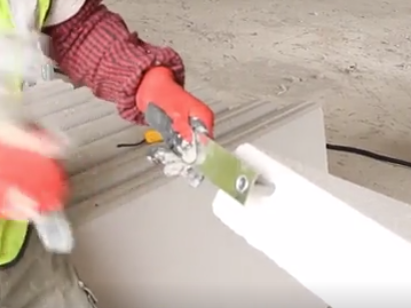

c. While installing the first panel, L-Type fasteners should be nailed in both sides of the top and outer side of the bottom.


Preparation before installation-c


(Mark: 1. Start with the second panel, L-Type fasteners should be nailed in outer side of the top and bottom.

           2. If the panel is connected to the structural column or external wall, L-Type fasteners should be added on the upper and lower ends on the side of the structural column or external wall. If the fasteners spacing is greater than 1500mm, another fastener should be added in the middle.)

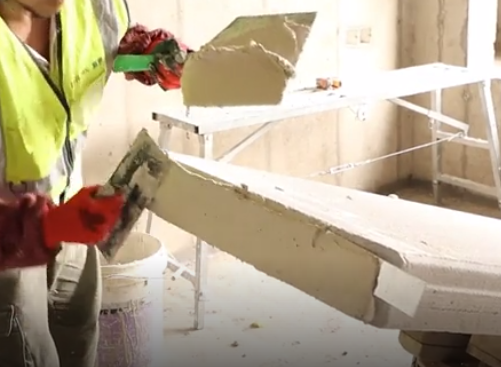

d. Before install the first panel, special adhesive mortar should be applied on the top of the panel and the vertical side connecting the external wall and structural column.


Preparation before installation-d-1Preparation before installation-d-2



   3). Installation of panel


a. lift up the panel from the trolley, and adjust the perpendicularity and installation position.

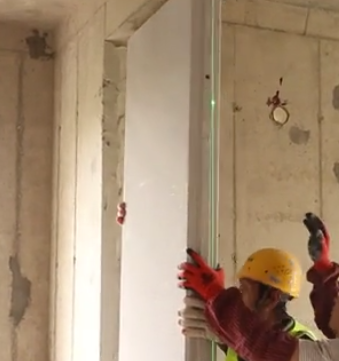

 2). Preparation before installation-a


b. Insert wood wedges at the top and bottom of each panel to hold.


 2). Preparation before installation-b

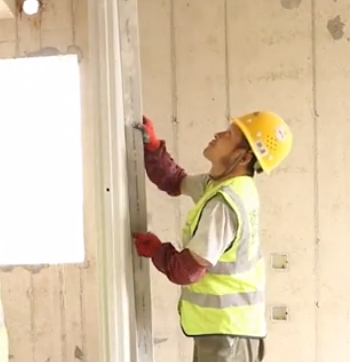

c. By using the level ruler to check the flatness of the wall panel to make sure the installation error of the wall panel should be controlled within 3 mm.


 2). Preparation before installation-c

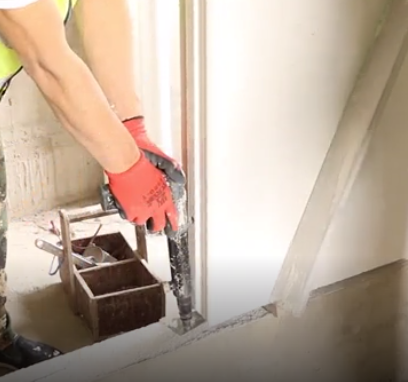

d. By using a nail gun to shoot nails into the L-Type fasteners on the top and bottom of the wall panel in order to fix to the structural beams and foundation.


 2). Preparation before installation-d-1 2). Preparation before installation-d-2


e. Special adhesive mortar should be applied on the outer side of the panel to connect with the next panel.


 2). Preparation before installation-e

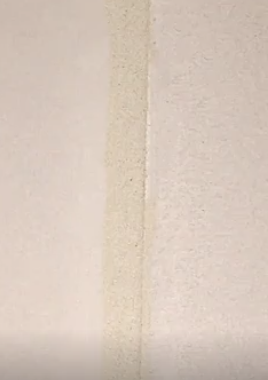

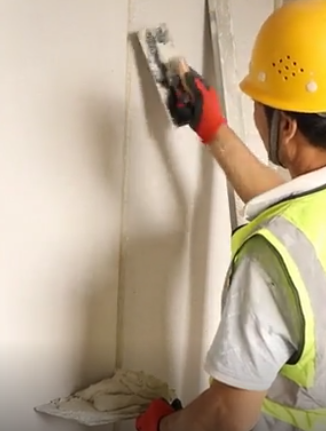

f. The joint between panels should be made level.


 2). Preparation before installation-f-1 2). Preparation before installation-f-2


(Mark: 1. Position adjustment should be finished within 20 minutes after applying with the special adhesive mortar. Otherwise, it may affect the adhesive strength.)


g. Each installed panel should adjust the position and then fix.

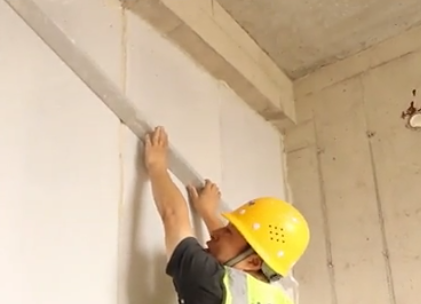

h. The installation quality should be checked after entire wall is installed.


 2). Preparation before installation-h

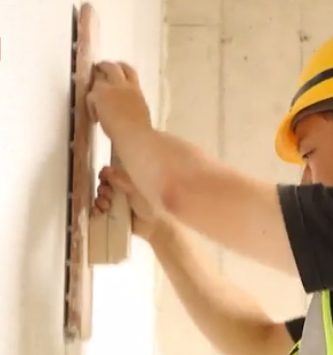

i. Deviation walls should be corrected by using frosted trowel and rubber hammer.


 2). Preparation before installation-i


j. Places with holes should be repaired with special repair mortar.


k. Once the installation is finished and quality met the requirement, the lower end of the wall panel should be inlaid with 1:3 cement mortar.

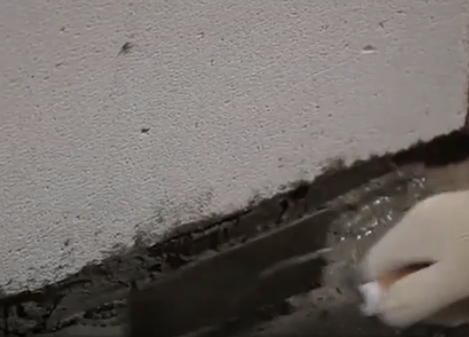

 2). Preparation before installation-k


(Mark: 1. Wood wedges can be pulled out after 24 hours of installation, and repair with 1:3 cement mortar.

            2. Wall slotting should be operated after 7 days of installation to avoid adhesive cracking.)



IMG_20200929_151553

Done!
